Excavation at the Tagore cut and cover tunnel has completed and the base slab has been concreted between GL5-7. Excavation of the tunnels between TGR and LTR are progressing. The Woodlands bound tunnel is now at ring 99 (12% completed). The TBM boring the Changi bound tunnel is experiencing problematic ground conditions over the past month, and regular interventions are being carried out to unclog the cutters (ring 60, 7% completed)
TBM B is in the process of assembly works at the second launch shaft and tunnelling works to Springleaf for the Woodlands Bound tunnel should start by January.
 |

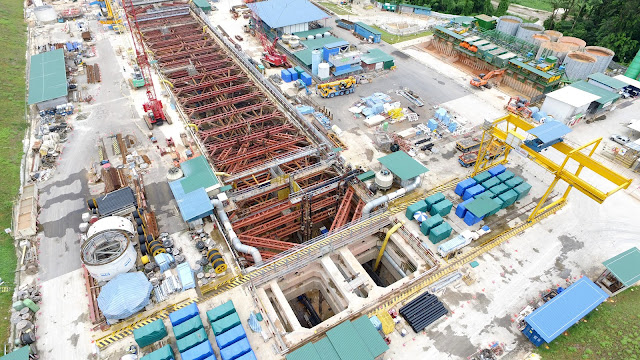

| Assembly works for TBM B |
 |

| Cutterhead and front/rear shield on the surface of the shaft |
 |

| Backup cradle assembled for the machine |
 |

| Tunnel route to Springleaf station |
 |

| STP in full operation |
 |

| Launch shaft to Lentor |
 |
| Spare TBM shield at the shaft portal, believed to be used for the relaunch of TBM C |
 |

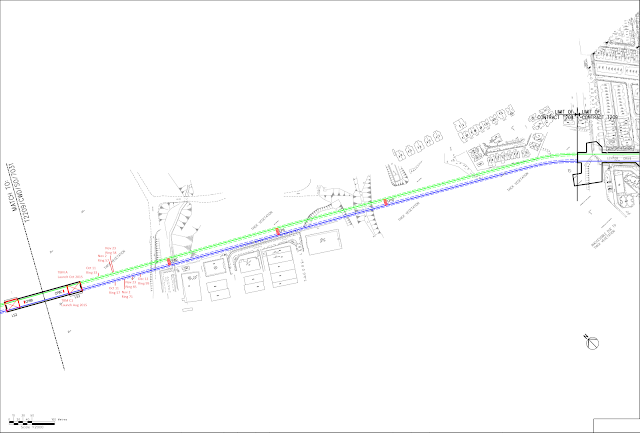

| Tunnel progress of the TBMs to Lentor |
 |
| Completion of ground improvement works at the cross passages |
No comments:
Post a Comment
Note: only a member of this blog may post a comment.
